- The G703 is the detail by SOV line; the G702 is the nine-line summary.
- G702 line 4 must equal the G703 column G total.
- Only approved change orders belong in line 2.
- Check billed against earned before you submit — under-billing is money left behind.
AIA G702 example: the nine lines filled in
The G702 summarises the G703 in nine lines, ending in the payment due. This AIA G702 example uses a $4,000,000 contract with one approved change order, 10% retainage and $900,000 previously certified.
| Line | Item | Amount |
|---|---|---|
| 1 | Original contract sum | $4,000,000 |
| 2 | Net change by change orders | $100,000 |
| 3 | Contract sum to date (1 + 2) | $4,100,000 |
| 4 | Total completed and stored to date (from G703) | $1,230,000 |
| 5 | Retainage, 10% of line 4 | $123,000 |
| 6 | Total earned less retainage (4 − 5) | $1,107,000 |
| 7 | Less previous certificates for payment | $900,000 |
| 8 | Current payment due (6 − 7) | $207,000 |
| 9 | Balance to finish, including retainage (3 − 6) | $2,993,000 |
The sample is worked for illustration. The full filled-in G702 and G703 below, with stored materials and a free download, tie out line by line.
AIA G702 example and free download
A complete, filled-in AIA G702 and G703 example that ties out line by line is below: a $3.86M contract, pay application No. 6, with two approved change orders, stored materials and 10% retainage. The same continuation sheet is free to download:
- G703 continuation sheet in Excel, with the formulas filled down
- G703 continuation sheet as a PDF to print
- The worked sample G703 as a PDF
The official AIA documents are licensed by AIA; these are working equivalents that follow the same columns, for checking the numbers before the pay application goes out.
The G703 continuation sheet
The G703 is the detail: one row per schedule-of-values line.
| Column | What goes in it |
|---|---|
| A · Item no. | The SOV line number |
| B · Description | The scope of that line |
| C · Scheduled value | The line’s share of the contract sum |
| D · From previous application | Work completed on earlier applications |
| E · This period | Work completed since the last application |
| F · Materials presently stored | Stored materials not yet in D or E |
| G · Completed and stored to date | D + E + F, with G ÷ C as the % complete |
| H · Balance to finish | C − G |
| I · Retainage | If the rate varies by line |
The G702, line by line
| 1 | Original contract sum |
| 2 | Net change by change orders (approved only) |
| 3 | Contract sum to date = 1 ± 2 |
| 4 | Total completed and stored to date = G703 column G total |
| 5 | Retainage on completed work and stored material |
| 6 | Total earned less retainage = 4 − 5 |
| 7 | Less previous certificates for payment |
| 8 | Current payment due = 6 − 7 |
| 9 | Balance to finish, including retainage = 3 − 6 |

AIA G702 sample: a filled-in G702 and G703
Riverside Apartments, job J-1104, pay application No. 6: original contract $3,862,000 plus two approved change orders, 10% retainage. The G703 continuation sheet comes first — one row per schedule of values line, with the change orders as their own lines:
| A | B · Description | C · Scheduled value | D · Previous | E · This period | F · Stored | G · Completed & stored | G ÷ C | H · Balance | I · Retainage 10% |
|---|---|---|---|---|---|---|---|---|---|
| 1 | General conditions | $386,000 | $96,500 | $18,500 | $0 | $115,000 | 29.8% | $271,000 | $11,500 |
| 2 | Sitework | $210,000 | $210,000 | $0 | $0 | $210,000 | 100.0% | $0 | $21,000 |
| 3 | Concrete | $540,000 | $378,000 | $54,000 | $0 | $432,000 | 80.0% | $108,000 | $43,200 |
| 4 | Framing & rough carpentry | $610,000 | $120,000 | $44,400 | $0 | $164,400 | 27.0% | $445,600 | $16,440 |
| 5 | Roofing | $180,000 | $0 | $0 | $0 | $0 | 0.0% | $180,000 | $0 |
| 6 | Doors, windows & glazing | $290,000 | $0 | $0 | $40,000 | $40,000 | 13.8% | $250,000 | $4,000 |
| 7 | Drywall & finishes | $520,000 | $0 | $0 | $0 | $0 | 0.0% | $520,000 | $0 |
| 8 | Plumbing | $360,000 | $40,000 | $14,000 | $0 | $54,000 | 15.0% | $306,000 | $5,400 |
| 9 | HVAC | $410,000 | $30,000 | $11,000 | $0 | $41,000 | 10.0% | $369,000 | $4,100 |
| 10 | Electrical | $356,000 | $25,833 | $9,767 | $0 | $35,600 | 10.0% | $320,400 | $3,560 |
| CO-01 | Added storm drainage | $58,000 | $58,000 | $0 | $0 | $58,000 | 100.0% | $0 | $5,800 |
| CO-02 | Upgraded unit kitchens | $80,000 | $0 | $0 | $0 | $0 | 0.0% | $80,000 | $0 |
| Totals | $4,000,000 | $958,333 | $151,667 | $40,000 | $1,150,000 | 28.7% | $2,850,000 | $115,000 |
Column G’s total, $1,150,000, carries to line 4 of the G702. Line 6 is $40,000 of windows stored on site, billed in column F with delivery tickets. Download this G703 sample in Excel — columns G, H and I are formulas, so it re-totals when you type your own lines over it.

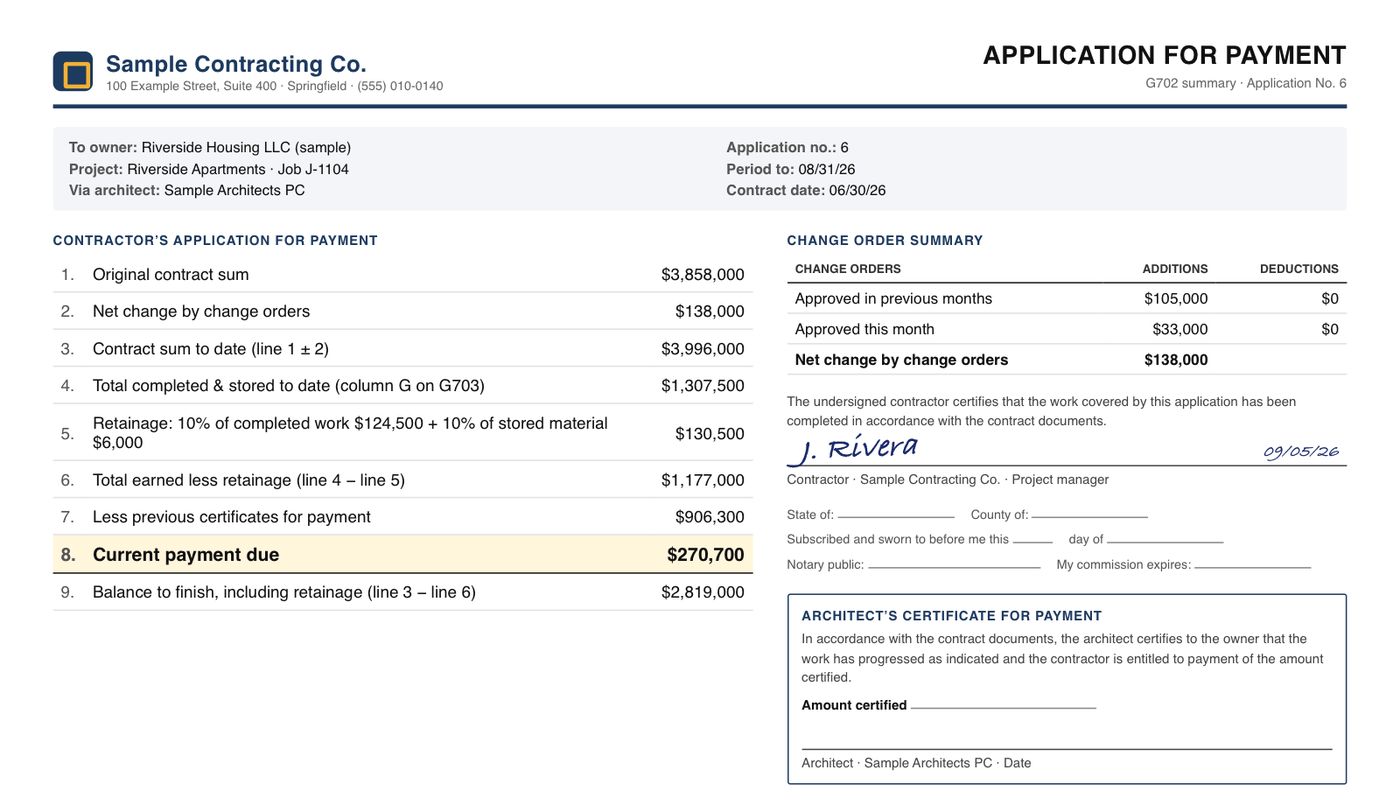

The G702 that goes on top of it:
Before it goes out, check it against the job: if the work is really 30% complete on a $4.0M contract, $1,200,000 is earned — this application is $50,000 under-billed.
For more inputs, a second forecast and a shareable link: the pay application & retainage calculator →
How to bill stored materials on a G702 and G703
Material delivered but not yet installed can be billed if the contract allows it — most AIA-based contracts do, with conditions. It goes in column F of the G703 on the line it belongs to, and leaves column F the period it is installed.
- Check the contract. Stored-material billing usually needs the owner's approval in advance, especially for material stored off site.
- Bill it in column F at invoice cost — $40,000 of windows on the windows line in the sample above. Column G (completed and stored) rises by the same amount, so it reaches G702 line 4.
- Attach the proof: supplier invoice, delivery tickets, photos, and for off-site storage, evidence of title, a bill of sale and insurance naming the owner.
- Retainage applies unless the contract says otherwise — G702 line 5 has its own line (5b) for retainage on stored material. At 10%, $4,000 of the $40,000 is held.
- Next period, move it. When the windows go in, the $40,000 moves from column F to column E (work completed this period). Column G does not change from the move — the material was already billed — so only new work increases it.
The most common rejection on stored materials is billing the full supplier price for material that is only partly delivered. Bill what is physically on site (or in approved storage) and backed by a ticket.
G702 vs G703: which does what
| G703 Continuation Sheet | G702 Application and Certificate for Payment | |
|---|---|---|
| Level | Detail — one row per schedule of values line | Summary — nine lines for the whole contract |
| Shows | Scheduled value, previous, this period, stored, % complete, balance, retainage per line | Contract sum, change orders, completed and stored, retainage, previous payments, payment due |
| Signed by | — (attached to the G702) | The contractor (notarised where required) and certified by the architect |
| Ties to | Column G total | Line 4 — must equal the G703 column G total |
They are always submitted together: the G703 shows where the money was earned, the G702 says how much is due. A G702 whose line 4 does not match its G703 is the first thing an architect sends back.
Why pay applications get sent back
- Line 2 includes change orders that are not yet approved.
- G703 column G doesn’t total to G702 line 4.
- Stored materials billed without proof of storage or insurance.
- Percent complete on a line runs ahead of what the architect sees on site.
- Missing lien waivers for the previous period.
Every one of these is a check a system can run before submission — the WIP & billing view in the demo compares billed with earned for each job.
Check it before it goes to the owner
Most rejected pay applications fail on arithmetic or on numbers that do not match the contract. Run these checks on every application before it is signed:
- On every G703 line: G (completed & stored) = D + E + F, and H (balance to finish) = C − G.
- Column G total on the G703 equals line 4 on the G702.
- The scheduled values (column C) total the original contract plus approved change orders — and only approved ones.
- Retainage is at the contract rate, applied the way the contract says (including any reduction after a milestone).
- Stored materials are documented, insured and on the approved list.
- Percent complete by line matches what the site can show.
The G703 PDF-to-Excel converter pulls a continuation sheet into a spreadsheet and flags lines where the columns do not add up; the pay application calculator checks the payment due.

A filled-in G703 sample — pay application No. 6 on a $4.0M job, twelve lines including two change orders — with columns A to I: item, description, scheduled value, previous, this period and stored, and completed and stored, percent, balance to finish and retainage calculated. Overwrite the lines with your own schedule of values.
10 columns: 6 you fill in and 4 calculated by formula and filled down 200 rows, so nothing is worked out by hand. In the Excel version, 4 columns reject entries of the wrong type (a date column only takes dates, an amount column only numbers), the header row stays frozen with filters on it, and the workbook opens on an Instructions sheet that lists every column below.
Every column, and how it is captured
| Column | Type | What goes in it |
|---|---|---|
| A Item | Text | Free text. |
| B Description | Text | Free text. |
| C Scheduled value | Amount ($) | Enter the amount in dollars. |
| D Previous | Amount ($) | Enter the amount in dollars. |
| E This period | Amount ($) | Enter the amount in dollars. |
| F Stored | Amount ($) | Enter the amount in dollars. |
| G Completed & stored | Calculated | Calculated: [D Previous] + [E This period] + [F Stored] |
| % (G/C) | Calculated | Calculated: IF([C Scheduled value]=0, blank, [G Completed & stored] ÷ [C Scheduled value]) |
| H Balance to finish | Calculated | Calculated: [C Scheduled value] − [G Completed & stored] |
| I Retainage | Calculated | Calculated: [G Completed & stored] × 0.1 |
See it on real-looking numbers
Constructelligence is a construction intelligence platform: it reads your ERP, project and field systems read-only and does this arithmetic every week, for every job. The demo runs it on a sample eight-job portfolio.
Try the demoJoin the private betaFrequently asked questions
What is an AIA G702?
The AIA G702 Application and Certificate for Payment is a one-page summary of a contractor's progress billing: contract sum, work completed, retainage, previous payments and the current payment due. It is certified by the architect before the owner pays.
What is the difference between G702 and G703?
The G703 continuation sheet lists each schedule-of-values line with work completed to date; the G702 summarises those totals into nine lines ending in the current payment due. Line 4 of the G702 equals the column G total of the G703.
How is current payment due calculated on a G702?
Take total completed and stored to date, subtract retainage to get total earned less retainage, then subtract previous certificates for payment. The result is line 8, current payment due.
Where can I get an AIA G702 and G703 sample?
The worked example on this page is a complete sample: a $4.0M job at pay application No. 6, with every G702 line and the twelve G703 lines behind it. The same G703 is a free Excel download with columns G, H and I calculated. The official AIA forms themselves are licensed from AIA Contract Documents; many owners accept a continuation sheet in the same column layout.
Can unapproved change orders go on a pay application?
They should not be included in line 2, net change by change orders. Bill change orders once approved; unapproved work belongs in change order requests, not the pay application.
Why do pay applications get rejected?
Most often for arithmetic errors on the continuation sheet, scheduled values that include unapproved changes, retainage calculated at the wrong rate, or stored materials without documentation.
